Pillar guide: Planning and the building
Legga questo articolo in italiano.
Unauthorised building work in Italy: spot an abuso

On this page
A house can be mapped, taxed and occupied while its building work is still illegal. Learn how to match the building, the Comune file and the Catasto before you inherit somebody else’s problem.
Already have a parcel in mind? The report runs these checks on your land, with a source and date for every finding: €29 in English or Italian · €39 in both languages. Find it on the map →
An enclosed veranda, an extended floor or a store converted into living space calls for comparison with the approved drawings. Listing photographs can help flag differences to your technical professional, who needs to read the municipal file alongside a survey.
That is an abuso edilizio: building work carried out without the required title, or not as the title allowed. It does not have to look dramatic. A closed veranda, a moved staircase, a converted storeroom, an extra bathroom or a house that is larger than the approved drawings can be enough.
If you are buying an Italian house with land, make this check part of the same early work as the visura catastale, the CDU and the planning check described in what you can build in Italy. If the parcel also carries a vincolo paesaggistico or sits in a hazard class, read those checks before you price the risk. The order matters. A clean-looking cadastral record does not rescue an unauthorised building.
In short
- Before paying a deposit, compare the actual building with municipal approvals and drawings.
- Obtain the outcome of any condono application; a pending file does not establish regularisation.
- A technical professional checks building compliance; the notary handles the deed’s declarations and formal requirements.
Two different problems hide under the word “irregular”
The word difformità does not identify the nature or extent of a defect. Ask: irregular in which record, and by how much?
A formal or documentary irregularity may be a missing reference, an old drawing that does not show a minor internal change, a cadastral plan that was never updated, or a file whose paperwork is incomplete. It can still delay a sale. Some defects can be corrected with a cadastral update, a later filing or a technical reconstruction of the stato legittimo.
A substantial planning illegality is different. The built work may exceed the permitted volume, sit outside the authorised footprint, change use without the required title, breach a condition of the permit, or exist where no permit was issued. The Comune can order removal or demolition. In the more serious cases, the issue is not “which form do we file?” but whether the work can legally remain at all.
The Catasto is a tax and land-record system, not the authority that grants planning permission. The Agenzia delle Entrate’s buying guide requires the deed to identify the cadastral data and planimetria and to contain a declaration that the real situation matches them. That is cadastral conformity, not proof that the Comune approved the building.
The two records must agree with the physical building, but they answer different questions:
Cadastral and urbanistic conformity are different checks
| Check | What it compares | What a mismatch means |
|---|---|---|
| Conformità catastale | The building on site against the Catasto Fabbricati data and planimetria | The deed declaration may be defective; an update may be needed, but a new plan does not authorise the work |
| Conformità urbanistica-edilizia | The building on site against the Comune’s titles, approved drawings, variants and lawful historic evidence | The work may be an abuso, require a national sanatoria route, need removal, or be impossible to regularise |
Source: Agenzia delle Entrate, buying guide and cadastral declaration
Do not let anyone “solve” an urbanistic problem by sending a new plan to the Catasto. That only makes the paper trail worse.
The legal route is national, but the planning rules applied to the property also come from the relevant regional law and the Comune’s PRG, PUC, PGT or NTA. That is why a rule that sounds national can produce a different answer in two municipalities.
What the deed has to say
For buildings started after 17 March 1985, Article 46 of DPR 380/2001 makes certain transfers of real rights void if the deed does not state the details of the permesso di costruire or the permit in sanatoria. Article 40 of Law 47/1985 covers the older statutory situation and requires the relevant licence, concession, sanatoria details or the prescribed historic declaration for the acts it covers.
The rule does not permit an arbitrary number in the deed. The title must exist and relate to that building. The Supreme Court’s Sezioni Unite, judgment no. 8230/2019, treats this as a formal statutory nullity: a real, identifiable title mentioned in the deed is the central test for that particular nullity, even though physical non-conformities can still trigger other disputes and sanctions. A fabricated or unrelated title is not a cure. An untrue declaration can therefore leave the sale void where it means the deed lacks a real, referable title, and it can expose the seller to the consequences of a false declaration under Article 76 of DPR 445/2000. The narrower Supreme Court rule still matters: a real title does not, by itself, make every physical difference a deed-nullity case.
There is a second deed check. Under the cadastral rules explained by the Agenzia delle Entrate, the urban unit’s cadastral identifiers and planimetria must be stated, with a declaration that the actual state matches them or an attestation from an authorised technician. That declaration does not replace the urbanistic file. You need both sides checked before the notary prepares the final wording.
| Document | What it means | What it does not prove | First step |
|---|---|---|---|
| Permit details in the deed | For buildings started after 17 March 1985 the deed must state them or it is void; earlier, Law 47/1985, Article 40 applies | That the building matches the drawings: a real permit does not make every physical difference lawful | Your technician compares permit, approved drawings and building |
| Cadastral plan and declaration | That the cadastral data match the building as it stands, declared in the deed | Municipal approval of the works | The Comune’s building file |
| A filed condono application | That someone applied | Approval, full payment, opinions or the amnesty permit | Application, receipts, opinions and the final decision |
| Agibilità | Safety, hygiene, systems and conformity with the filed design (Article 24) | A retroactive planning permit | The document, or the reason it was never filed |
For the Joint Sections the nullity is formal: what counts is a real permit that refers to that building. Physical discrepancies are a separate problem. Sources: DPR 380/2001, Article 46; Law 47/1985, Article 40; Court of Cassation, Joint Sections, judgment 8230/2019; Agenzia delle Entrate, buying a home; DPR 380/2001, consolidated text; accessed 28 August 2026.
The three condoni are not three open doors
Condono edilizio is an exceptional amnesty created by a specific law. Ordinary sanatoria is a route within the current building-control system. They are not synonyms, and there is no permanent application window for a new condono just because a seller uses the word confidently.
The three condono regimes
| Law | Works cut-off in the national rule | What the buyer should understand |
|---|---|---|
| Law 47/1985, first condono | Completed by 1 October 1983 | Historic applications may still be in municipal archives; the application, payments, drawings and final measure must be checked |
| Law 724/1994, second condono, Article 39 | Completed by 31 December 1993; new construction applications were subject to a 750 m³ limit per request | The law extended the first framework with new limits; regional and municipal processing still matters |
| Law 326/2003, third condono, Article 32 of Decree-Law 269/2003 as converted | Completed by 31 March 2003 | The law preserved regional and local competences and applied tighter categories and exclusions; do not assume a national yes |
Source: Law 47/1985, Law 724/1994 Article 39 and Article 32 of Decree-Law 269/2003.
The cut-off dates are statutory, not estimates. They tell you when work had to be finished to enter a scheme, not whether a particular building qualified.
The three national condono windows
- Law 47/1985 · works cut-off1 October 1983
- Law 47/1985 · law date28 February 1985
- Law 724/1994 · works cut-off31 December 1993
- Law 724/1994 · law date23 December 1994
- Law 326/2003 · works cut-off31 March 2003
- Law 326/2003 · law date24 November 2003
Source: Normattiva, Law 47/1985 Articles 31 and 40; Law 724/1994 Article 39; Decree-Law 269/2003 Article 32
A pending condono is not a completed condono
Buyers lose months here. A stamped domanda di condono proves only that someone applied. It does not prove acceptance, full payment of oblazione and charges, the required opinions, or a final concessione in sanatoria.
Ask for the full file: application, protocol number, drawings, photographs, every payment receipt, integration requests, opinions, refusal if any, final concession or legally effective silence-assent, and cadastral update. The Comune’s procedure is local. Milan, for example, publishes separate routes for ordinary building files and the first, second and third condono files. That is a model of what to request, not a national fee or deadline.
Do not accept “the condono is automatic”. A pending file can contain a missing payment, wrong volume, protected-area problem, regional exclusion or unanswered document request. Protect the point in the preliminary contract, or price the risk as if the work were still unauthorised. A seller who refuses to release the file has answered your question.
Hypothetical example
A “finished” amnesty without a decision
The seller hands over the receipt for a 1986 condono application for a storeroom turned into a home. The municipal file holds no amnesty permit and two payments are missing. The buyer pays no deposit until the Comune confirms the status of the file, and treats the work as still unauthorised.
Sources: Comune di Milano, access to condono files; accessed 28 August 2026.
Ordinary sanatoria: double conformity, then the Salva Casa exception
Article 36 of DPR 380/2001 is the classic accertamento di conformità for work without a permit or in total difformity. The work must satisfy the planning and building rules in force when it was built and when the application is made. That is doppia conformità. A later plan change does not ordinarily cure an earlier illegality under Article 36.
Article 37 concerns works requiring a SCIA that were carried out without it or contrary to it, with its own sanction and procedure. The technician must classify the work first. Calling a new room a “CILA issue” does not make it one.
The 2024 Salva Casa reform is Law 105/2024, converting Decree-Law 69/2024. It changed Article 34-bis, added Article 34-ter for particular old in-course variants, and inserted Article 36-bis. The MIT’s January 2025 guidelines describe a defined easing for partial differences, certain essential variations and specified SCIA cases, not a general amnesty.
The practical numbers matter:
Source: Normattiva, DPR 380/2001 Article 34-bis, text in force from 28 July 2024; Law 105/2024, conversion of Decree-Law 69/2024
Article 36-bis relaxes the old double-conformity test only for its named categories. The work must comply with planning rules in force when the application is made and building requirements in force when it was carried out. That is not “anything legal today can be saved”. The work must fit Article 36-bis, the evidence must establish what was built and when, and the Comune must process the application.
For an Article 36-bis permit in sanatoria, the Comune’s decision period is 45 days; for a SCIA in sanatoria, 30 days. A landscape-protected property adds another authority: Article 36-bis of DPR 380/2001 gives the compatibility assessment 180 days, with a binding Soprintendenza opinion due within 90 days, and the municipal period is suspended meanwhile. These are procedural numbers, not a promise that a file will be complete in 45 days.
- Article 34-bis tolerance bandsWork completed by 24 May 2024; test tolerance against the existing title first
- Article 36-bisPartial difference, specified essential variation or Article 37 SCIA absence/difference; 45 days permit or 30 days SCIA
- Article 36Absence or total difference outside Article 36-bis; two conformity dates; 60-day decision and silence is rejection
- No route or refusalArticle 31: demolition and, after an ignored order, acquisition by the Comune; Article 34 (partial difference): removal or demolition, or a fine where demolition would harm the compliant part
Source: Normattiva, DPR 380/2001 Articles 31, 34, 34-bis, 36, 36-bis, 37 and 46, consolidated text; Ministero delle infrastrutture e dei trasporti, Salva Casa guidelines; Regione Lazio, Article 36-bis procedure
Salva Casa did not legalise a complete unauthorised house, erase a demolition order, replace a landscape authorisation or turn a pending municipal file into an approval. It did not make the Catasto a planning authority. A technician still has to reconstruct the title history and the Comune still has to decide the case.
Which route for which discrepancy
- Article 34-bis tolerancesWorks finished by 24 May 2024: first check the tolerance against the existing permit.
- Article 36-bisPartial discrepancy, a listed essential variation, or a missing or non-matching SCIA: the Comune decides in 45 days on a permit and 30 on a SCIA.
- Article 36No permit or total discrepancy outside Article 36-bis: double conformity, a decision in 60 days, and silence counts as refusal.
- No regularisation possibleArticle 31: demolition and, if the order is ignored, transfer to the Comune. Article 34: removal, or a fine if demolition would harm the lawful part.
Under landscape protection the compatibility check has 180 days, with a binding Soprintendenza opinion within 90, and the municipal clock stops. The MIT guidelines describe the reform as a limited easing, not an amnesty. Sources: DPR 380/2001, Article 34-bis; DPR 380/2001, Articles 36, 36-bis and 37; DPR 380/2001, Article 31; DPR 380/2001, Article 34; MIT, Salva Casa guidelines; accessed 28 August 2026.
How to detect an abuso before signing
1. Walk the building with the planimetria
Obtain the current cadastral plan and walk every room. Count the doors, windows, stair flights, bathrooms, enclosed terraces, garages, storage spaces and external structures. Check the footprint, not just the internal walls. Compare the plan with photographs taken on the same visit.
The obvious clues are a veranda missing from the plan, a garage converted into a bedroom, a window in a blank wall, a second kitchen, a roof terrace enclosed with frames or a building on the parcel that does not appear in the Catasto at all. The less obvious clue is a building whose cadastral plan matches the present condition but whose permesso di costruire drawings do not. That is why the planimetria is the first filter, never the last word.
2. Pull the Comune’s pratica edilizia file
Request the fascicolo edilizio from the Comune’s SUE or archive. Give the technician the cadastral identifiers, address, owner’s details and every title the seller mentions. Ask for the original permit, approved drawings, variants, start and end-of-work filings, relevant structural or landscape filings, agibilità material, and enforcement or condono documents.
Municipal systems differ. Milan says its building-file service covers factory records and modifications from 1928 onward, while its condono service separately identifies the three condono laws. Another Comune may have paper archives, different fees, restricted access or a backlog. Do not assume that an online search showing no result means no file exists. Ask the archive how it searches historic addresses and parcel numbers.
The technician should compare the approved drawings to the building dimension by dimension. “The permit exists” is not the conclusion. The question is whether the permit describes this building.
3. Compare aerial images over time
Use the official cadastral map and available orthophotos as a chronology aid. The Agenzia del Territorio described its national “undeclared buildings” check as starting with high-resolution orthophoto and cadastral-map overlays. An extension appearing between two image dates gives you a construction window to test against the Comune file.
It is evidence, not a permit. Resolution, image date, tree cover, shadows and georeferencing can mislead. A small roof, internal change or demolished structure may never show. Use the images to ask better questions, then prove the answer with dated titles, technical records and the municipal archive.
Sources: Agenzia del Territorio, undeclared buildings; Comune di Milano, access to building files; accessed 28 August 2026.
The consequences are practical, not theoretical
An enforcement order can require removal or demolition at the responsible party’s expense. Under Article 31 of DPR 380/2001, the standard period after an ingiunzione di demolizione is 90 days. Non-compliance can lead to free acquisition by the Comune of the property and necessary area, capped at ten times the abusive useful surface. Article 31 also provides a €2,000–€20,000 penalty, with the maximum applying to certain high or very high hydrogeological-risk areas.
Statutory consequences and figures
| Statutory figure | Unit | Why it matters to a buyer |
|---|---|---|
| 90 | days | The normal compliance period after the demolition injunction in Article 31(3) |
| 10 | times | Maximum ratio for the area acquired under Article 31(3), measured against the abusive useful surface |
| €2,000–€20,000 | administrative penalty | Article 31(4-bis) penalty for non-compliance; some high-risk cases use the maximum |
| €77–€464 | administrative penalty | Article 24(3) penalty for failing to submit the agibilità notification where required |
Source: DPR 380/2001 Articles 24 and 31
These are national statutory figures. A region may increase certain Article 31 penalties under Article 31(4-quater), and local enforcement, technical conditions and protected-area rules can add more complications. The figures do not estimate demolition cost. Nobody can tell you that from a desk without seeing the building, the order and the access conditions.
Agibilità is not a retroactive planning permit. Article 24 links it to safety, hygiene, salubrity, energy saving, plant conditions and conformity to the submitted project. An unauthorised or materially different building may have no valid route to agibilità until the underlying problem is resolved. “It is inhabited” proves nothing.
A bank is not obliged to lend against a property because the seller can name a cadastral category. The Bank of Italy explains that the lender orders a technical appraisal and uses the property as mortgage security. An unresolved abuse can reduce the value, stop the appraisal or make the lender refuse the property as security. Keep the financing risk alongside the tax and closing costs covered in the cost of buying property in Italy. “The bank will sort it out” is a warning.
The market consequence is harsher than the legal vocabulary. A future buyer, notary or lender may reject the property, demand a reduction, require a completed sanatoria or insist on demolition. You can own an asset that is technically transferable in one narrow formal sense and still be unable to sell it on sensible terms. That is “unsellable” in practice.
What to demand from the seller
Before paying a non-refundable deposit, request:
- the current visura and planimetria catastale, plus historic cadastral documents where the building has changed;
- every permit, concession, DIA, SCIA, CILA, variant, end-of-work filing and structural filing the seller has;
- the complete Comune access-to-acts result, including a written statement of missing files if the archive cannot locate them;
- any condono application, every receipt, integration request, opinion, final concession or written refusal;
- the agibilità record or the reason it was never filed;
- landscape, hydrogeological, seismic or heritage approvals where the site requires them;
- written answers identifying who will pay, file and carry the risk if the technician finds a discrepancy.
Then commission an independent geometra, architect or engineer with a written scope. Ask for a comparison between the physical survey, cadastral plan, Comune titles, approved drawings, planning rules and the date of each work. Each finding should be labelled: cadastral correction, tolerance, ordinary sanatoria, Article 36-bis possibility, pending condono, demolition/removal risk or unresolved. “Compliant” without the documents is not a useful report.
Make the preliminary contract conditional on the result if the check is not finished. Set a deadline for the seller to provide the archive file. State who holds the deposit if the file reveals an abuse that cannot be regularised. Your notary handles the deed and legal drafting; your technician checks the building. One professional does not silently replace the other.

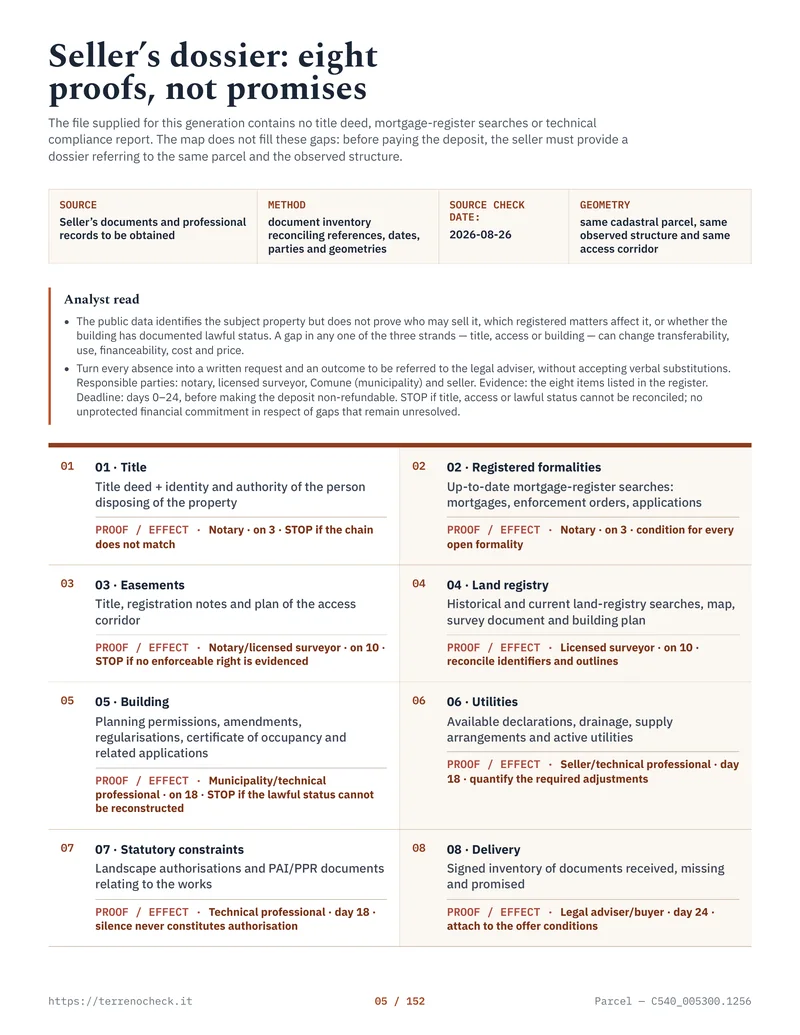

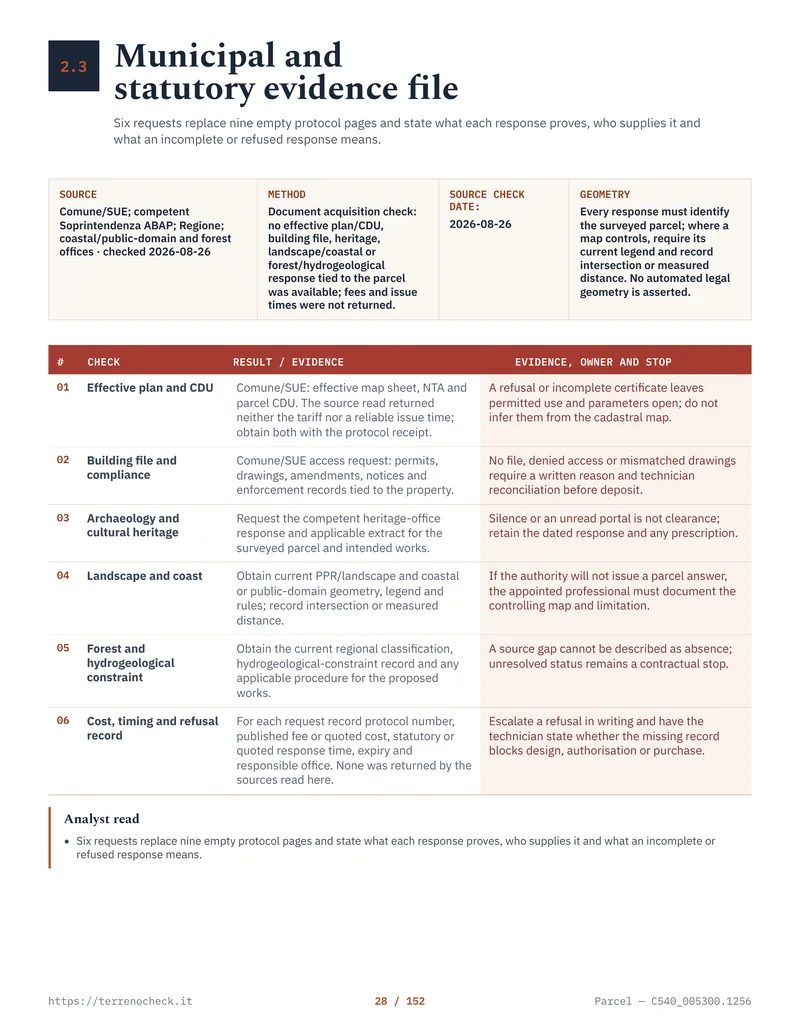

A page from a delivered report

Common questions
Can I buy a house in Italy with an abuso edilizio?
Sometimes, but the answer depends on the abuse, deed wording, title history, sanatoria route and enforcement or protected-area issues. A pending condono is not completed. Do not sign on a promise to fix it after closing unless the exact route, evidence, cost allocation and contract protection are written down.
Does a cadastral plan prove that a house is legal in Italy?
No. It can support the required cadastral declaration and reveal a mismatch with the physical building. Planning legality comes from the Comune’s building titles and the lawful historic evidence described in DPR 380/2001, not from the tax map alone.
What is the difference between condono and sanatoria?
Condono is an exceptional statute for works falling within a defined historic scheme, such as Laws 47/1985, 724/1994 and 326/2003. Sanatoria is the ordinary planning procedure under the DPR 380/2001, including Article 36, Article 37 and the defined Article 36-bis route. A seller who uses the words interchangeably has not yet given you a legal answer.
Does Salva Casa make small building discrepancies legal?
It introduced defined tolerances and a narrower Article 36-bis procedure. The percentages depend on authorised useful surface and, for the special bands, work completed by 24 May 2024. It does not authorise a new extension or remove every planning or landscape restriction.
How long does an Italian Comune take to approve a sanatoria?
The legal period depends on the route. Article 36 has a 60-day decision period with silence rejection. Article 36-bis provides 45 days for a permit in sanatoria and 30 days for a SCIA in sanatoria, subject to completeness and the special rules for landscape compatibility. A local office may need integrations, and a landscape opinion can suspend the municipal clock. Ask for the protocol date and the statutory route, not a casual estimate.
What is the first document I should ask the seller for?
Ask for the complete Comune building file and the current cadastral plan together. Either one on its own can mislead. Then have an independent technician visit the building and compare the physical state to both records before you commit to the purchase.
