Pillar guide: Planning and the building
Legga questo articolo in italiano.
Can you build on land in Italy? PRG, PUC and zoning

On this page
To establish whether you can build on land in Italy, have your specific project checked against effective and adopted municipal plans, remaining capacity and constraints before paying a deposit.
Already have a parcel in mind? The report runs these checks on your land, with a source and date for every finding: €29 in English or Italian · €39 in both languages. Find it on the map →
In short
- Check the description “building land” against your specific project, the relevant part of the plot and the applicable rules.
- PRG, PUC, PUG, PGT and PAT/PI belong to different regional systems: obtain the municipality’s actual planning documents.
- The index gives a theoretical quantity; minimum plot size, capacity already used and setbacks can prevent its use.
- Before signing, obtain a written technical opinion and have the notary address outstanding investigations in the contract.
0.03 m³/m²
Housing in Zone E
The decree’s maximum plot density, not a right to build.
3 / 5 years
Safeguard measures
From adoption; the longer period requires the specified submission condition.
IF / IT
Different index bases
Net plot or territorial area; check units and local definitions.
How to check whether land in Italy is buildable
One parcel can cross several planning zones. To read it, obtain the plan sheet with its legend and the implementing rules, rather than relying on a zoning letter in the listing.
Start with the cadastral municipality, map sheet and parcel number, then have the land located on the planning map. A parcel can cross different designations: its recorded cadastral area does not automatically become the land area used in the calculation. Request the certificato di destinazione urbanistica (CDU, the municipal planning certificate) and the Norme Tecniche di Attuazione (NTA, the plan’s implementing rules) it cites. Roma Capitale’s Guide to CDU and PRG searches explains reading the certificate alongside maps and rules; its document format is specific to Rome.
DPR 380/2001, Article 12 requires compliance with planning instruments, building regulations and current planning and building rules. Paragraph 2 makes the permit depend on primary infrastructure (urbanizzazione primaria) such as the road and utility networks: it must exist, be scheduled by the municipality within the next three years, or be built by the applicant together with the house.
Buildability: three questions in order
Can anything be built?
- Zone in the CDUThe homogeneous zone and its NTA rules say what is allowed; in agricultural zone E regional rules apply
- Overriding constraintsLandscape, PAI and seismic rules can require consent or forbid the work even in a building zone
- Building permitA permesso di costruire is granted for a project, not for the land: the CDU does not replace it
Source: DPR 380/2001, Articles 10, 20 and 30; DM 1444/1968, Article 2 (checked 15 October 2026)
Ask which provision allows your project, on which part of the land and under what conditions. You will find a printable checklist at the end of the page. The TerrenoCheck report brings public data together to direct further investigation; it does not certify ownership, title or buildability, and does not replace a professional opinion.
Four answers to get before talking about volume
- Zone and sub-zoneWhich part of the land falls in each zone: the plan map with its key and the NTA articles, not the letter quoted in the listing.
- The rule that allows the worksWhich article permits your project, on which part of the plot and on what conditions.
- Primary infrastructureRoad and networks must exist, be planned by the Comune within the next three years, or be built by the applicant with the works.
- ProcedureDirect works, or an implementing plan to be approved before the project.
A permit requires compliance with the planning instruments, the building regulations and the rules in force. Sources: DPR 380/2001, Article 12; Roma Capitale, guide to CDU and PRG searches; accessed 15 October 2026.
How to calculate the building index and permitted volume
First establish which area the index applies to and in which units. Then multiply that area by the index and check the capacity already used and the other parameters.
The indice di fabbricabilità fondiaria (plot building index), IF, applies to superficie fondiaria (SF, net building land area). The indice territoriale (territorial index), IT, applies to superficie territoriale (ST, the overall development area), including territorial infrastructure and facilities. The Intesa of 20 October 2016, Annex A, entries 1–4 distinguishes these areas and calls IF and IT development indices, including existing development within the allowance. Check terminology and methods against local definitions and NTA.
An index in m³/m² produces volume; in m²/m², floor area. Dividing volume by an assumed height does not establish habitable space: walls, floors and ancillary rooms follow local definitions.
Entirely hypothetical assumptions: residential use and direct development already checked; verified net plot area equal to the purchase area; uniform volume-based index; existing lawful building retained and counted in full; no capacity transfers or other commitments. These educational figures do not come from the Diano San Pietro sample report.
In one line: 1,000 m² × 0.50 m³/m² = 500 m³; less 200 m³ existing leaves 300 m³, on a plot above the 800 m² minimum.
| Step | Value and calculation |
|---|---|
| Area and index | Eligible net plot area: 1,000 m²; volume-based plot index: 0.50 m³/m² |
| Total theoretical volume | 1,000 × 0.50 = 500 m³ |
| Existing volume to remain | 200 m³, all countable and deducted |
| Arithmetical remainder | 500 − 200 = 300 m³ |
| Assumed minimum plot | 800 m² under the example’s rules; 1,000 ≥ 800: area requirement met |
| Outstanding checks | Setbacks, height, coverage and other provisions: the remainder does not establish that the building fits |
Source: educational calculation using hypothetical inputs; area and index distinctions follow the Intesa of 20 October 2016, Annex A. None of these figures is a requirement of a real municipality.
The lotto minimo (minimum eligible plot) remains separate: a smaller house does not satisfy it. Check which areas may be combined; common ownership of road or agricultural strips is insufficient.
Veneto LR 11/2004, Article 45 illustrates why these documents matter. For new rural dwellings it provides for a restriction against further building on the associated holding, recorded in property registers, and a municipal register of affected land. Elsewhere, your professional must establish the applicable mechanism in coordination with the notary. If the history remains incomplete, the remaining capacity should be recorded as undetermined.
What PRG, PUC, PUG and PGT mean in Italy
The plan’s name depends on regional legislation; it does not tell you how much you can build. Search the municipality’s website for the effective plan and its amendments using the local terminology.
| Territory | Planning instrument | Official reference |
|---|---|---|
| Piedmont, an example of PRG usage | Piano Regolatore Generale (general municipal plan), also PRGC | LR 56/1977, Art. 24 |
| Campania | PUC, Piano Urbanistico Comunale (municipal urban plan); current legislation divides it into PSU and RUE | LR 16/2004, Art. 22 |
| Liguria | PUC, Piano Urbanistico Comunale (municipal urban plan) | LR 36/1997 |
| Sardinia | PUC, Piano Urbanistico Comunale (municipal urban plan) | LR 45/1989, Art. 19 |
| Emilia-Romagna | PUG, Piano Urbanistico Generale (general urban plan), replacing PSC, POC and RUE | LR 24/2017, Arts. 3, 30–31 |
| Lombardy | PGT, Piano di Governo del Territorio (territorial governance plan): Documento di Piano (strategy), Piano dei Servizi (services), Piano delle Regole (rules) | LR 12/2005, Art. 7 |
| Veneto | PAT, Piano di Assetto del Territorio (structural territorial plan); PI, Piano degli Interventi (operational interventions plan) | LR 11/2004, Art. 12 |
In Emilia-Romagna, LR 24/2017, Article 3, read with Article 80 sets 1 January 2022 for starting the adjustment process and 1 January 2024 for completing it. Later dates in the regional PUG funding programme concern grants and funded activities, without a statutory extension to 2026: check which plan actually governs your purchase.
Which Italian planning zones A, B, C, D, E and F allow building?
Zones B and C may allow building, and Zone D may allow industrial or similar production uses, subject to the local plan and project requirements. Zones A and F follow heritage or public-use rules, and new homes in Zone E must meet the farming conditions set by the region and municipality.
The letters are planning categories, not a permission for an individual plot: DM 1444/1968, Articles 1 and 2 uses them as a framework for preparing and revising planning instruments. Work on existing buildings follows its own rules, including those for the building’s use; in Tuscany, for example, Tuscany’s LR 65/2014, Article 79 covers existing rural buildings with non-agricultural uses.
| Zone | Decree designation, summarised | Question for the buyer |
|---|---|---|
| A | Urban areas of historic, artistic or environmental value and their integrated surroundings | What changes do the protective rules allow? |
| B | Fully or partly developed areas outside A | Does an empty gap have independent capacity remaining? |
| C | Areas intended for new settlement complexes | Is an implementing plan required before the building project? |
| D | New industrial or similar developments | Is your proposed use compatible with productive zoning? |
| E | Agricultural uses; where subdivision calls for new settlements, the decree treats them as Zone C | What operator and business requirements apply locally? |
| F | Facilities and installations of general interest | Which facility is intended and how would it be delivered? |
Source: DM 1444/1968, Article 2. Read subzones and local equivalents in the municipality’s legend and implementing rules.
Subzones may require coordinated development or allow a direct application. A planning boundary or previous application can make a neighbour’s answer inapplicable to your plot.
Have your professional consult the competent sources for landscape and hazard constraints too, starting with the guide to PAI flood and landslide risk. Until a document arrives, treat that check as open.
Can you build a house on agricultural land in Zone E?
In Zone E, check regional and municipal rules for both the proposed work and the person proposing it. Buying farmland does not demonstrate an agricultural need for a new dwelling.
DM 1444/1968, Article 7, point 4 prescribes a maximum residential plot density of 0.03 m³/m². This is the decree’s ceiling for plans, rather than an index automatically allocated to every owner. It does not replace agricultural conditions, minimum holding requirements or local restrictions.
In Tuscany, LR 65/2014, Article 73, consolidated text allows an agricultural entrepreneur to erect new rural buildings only where needed for the business, giving priority to reusing existing buildings. For new dwellings permitted by the plans, it requires a business programme submitted by an imprenditore agricolo professionale (IAP, professional agricultural entrepreneur), evidence of need and a commitment to maintain minimum areas in production. Article 74 of the same LR 65/2014 governs the programme and its agreement or unilateral undertaking. This is a Tuscan example, not a rule for every region.
A new house, a farm outbuilding and the restoration of an existing building follow different rules. For an annesso agricolo (agricultural outbuilding), ask which rule permits your intended use. Light or movable structures also need professional classification.
Check whether agricultural qualifications fit your intended activity. Coordinate the separate agricultural pre-emption investigation with your notary when purchasing the holding.
Hypothetical example
Two hectares of farmland and a house to build
A buyer who is not a farmer looks at 20,000 m² in Zone E and multiplies the area by 0.03 m³/m²: 600 m³. The technician explains that the figure is a cap the decree sets for plans, not an index the land carries. In Tuscany new rural homes need a farm business plan filed by an IAP (professional farmer) and proof of farming need. The buyer negotiates the price as farmland.
Building setbacks, height and implementing plans in Italy

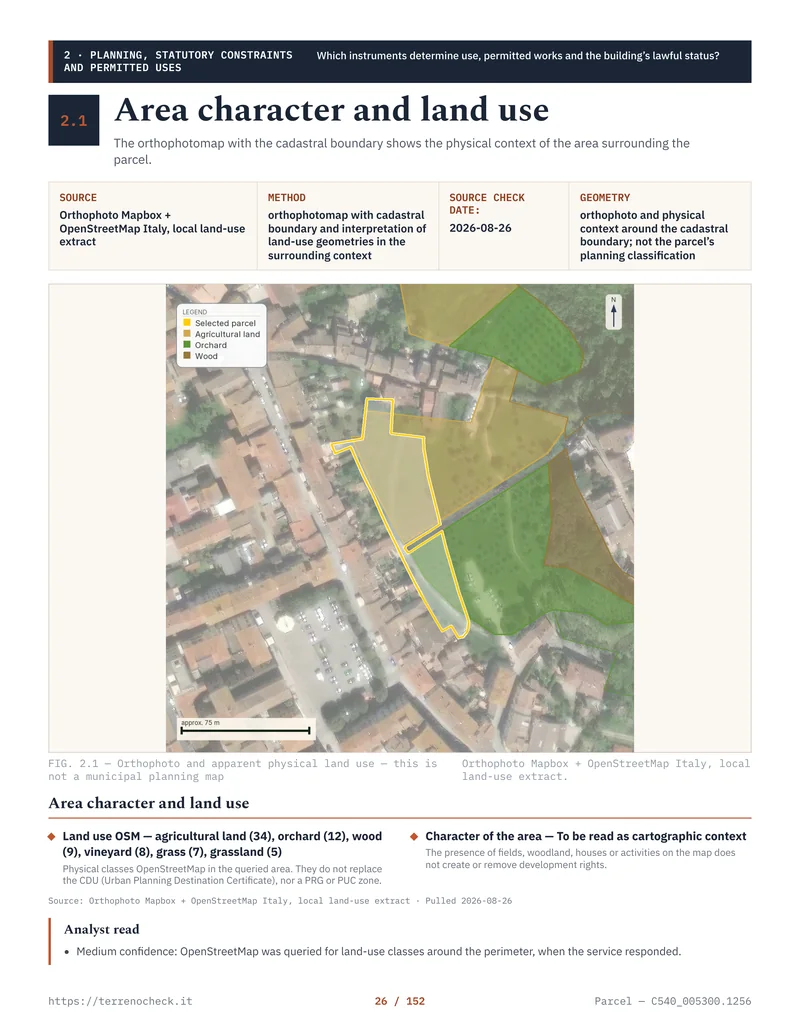

The proposed building must fit within the permitted footprint and height. The project must also follow the required approval procedure. Narrow plots or protected strips may prevent the house you want.

Source: TerrenoCheck, conceptual diagram
DM 1444/1968, Article 9 prescribes 10 metres between windowed walls and walls of opposing buildings for new buildings outside Zone A, within its stated conditions and exceptions. This is not a universal distance from the boundary or road edge. Your professional must also examine regional rules, NTA, building regulations and the rules for the specific type of work.
Request a section showing ground and proposed levels using the prescribed height reference. On sloping land, visible storeys can mislead. DM 1444/1968, Article 8 sets different rules by zone; choosing a convenient height for the volume calculation does not resolve them.
| Check | Document or answer required |
|---|---|
| Distances from buildings and boundaries | Dimensioned drawing identifying the rule used along each side |
| Road and access | Road classification, applicable strip and feasibility of an entrance |
| Height, coverage and permeability | Sections and areas calculated under local definitions |
| Implementing plan | Boundary, approval, effectiveness and rules for the plot |
| Planning agreement | Signed wording, remaining obligations, works and costs |
Source: DM 1444/1968, Articles 8–9; DPR 380/2001, Article 12; for a regional example of implementing-plan provisions, Veneto LR 11/2004, Articles 19–20.
A piano attuativo (implementing plan) details how an area will be developed. Its convenzione (planning agreement) governs associated commitments under the applicable rules. Obtain the agreement, outstanding obligations and funding arrangements for any infrastructure shared with other owners.
A water main in the road does not mean you can connect to it. Obtain quotations for necessary works and clarify which agreement obligations would pass to you.
Adopted versus approved plans: how long do safeguards last?
An adopted plan can affect a permit application before final approval. Your investigation must cover both the effective plan and adopted provisions, with their respective resolutions and dates.
Ask the municipality for the resolution and procedural steps establishing effectiveness under regional legislation. A filename saying “new plan” does not determine legal status.
Where an adopted plan changes the designation, have the conflict and consequences for the application identified. After safeguards expire, check any plan approved meanwhile, other applicable rules and permit prerequisites.
Record relevant adoption, publication-end and submission dates, plus the opinion’s reference date and update conditions. Recheck for amendments before completion.
| Moment | Effect on a permit application | What to ask for |
|---|---|---|
| Plan adopted | Any decision on applications that clash with the adopted plan is suspended | The adoption resolution and how it differs from the plan in force |
| Three years after adoption | The safeguard lapses, except in the case on the next row | Adoption date |
| Plan sent for approval within one year of the end of publication | The safeguard lasts five years | Dates of end of publication and of transmission to the approving authority |
| Safeguard lapsed | The approved plan, other rules and the conditions for a permit still need checking | An updated opinion stating its reference date |
The year runs from the end of publication, not from adoption; a vague “sent to the Region” is not enough. Sources: DPR 380/2001, Article 12; accessed 15 October 2026.
Building permit, SCIA or CILA: what to ask before a deposit
The procedure follows the classification of the work; it does not make a prohibited use permissible. A new house ordinarily falls under the building-permit route, subject to the statutory cases allowing an alternative SCIA.
| Procedure | Essential scope | Reference |
|---|---|---|
| Permesso di costruire (building permit) | New construction and other transformations specified by law | DPR 380/2001, original text published by Civil Protection, Article 10(1)(a) |
| Ordinary SCIA, segnalazione certificata di inizio attività (certified commencement notification) | Specified work including extraordinary maintenance (major repairs) and conservation affecting structural parts, and renovation outside permit cases | DPR 380/2001, Article 22; D.Lgs. 222/2016, Article 3(f) |
| SCIA alternative to a permit | Specifically permitted interventions, including certain new buildings governed by detailed plans | DPR 380/2001, Article 23; D.Lgs. 222/2016, Article 3(g) |
| CILA, comunicazione di inizio lavori asseverata (professionally certified works communication) | Residual route for work outside the lists for permit-free activity, permits and SCIA, with technical certification | DPR 380/2001, Article 6-bis; D.Lgs. 222/2016, Article 3(c) |
A geometra (surveying and building professional) or architect should identify additional consents and technical conditions. For existing buildings, compare applications with site conditions; see the unauthorised works guide.
Give the notary your written opinion and unresolved questions. If you will buy only to carry out that project, have the agreement specify which investigations must succeed, who undertakes them and what happens to money paid. The preliminary contract and deposit guide helps prepare that discussion. Generic wording such as “subject to checks” may leave the agreement uncertain.
When money moves
1Purchase offer
What you pay
any sum specified, with its purpose and custody clarified
If it goes wrong
you commit before knowing whether the project is allowed
Resolve before signing
plot identity, initial opinion and conditions for outstanding investigations
2Preliminary contract and deposit
What you pay
agreed deposit or price advance and agreed expenses
If it goes wrong
disputed money because remaining capacity or plan implementation is missing
Resolve before signing
project opinion, documented calculation and contractual treatment of the findings
3Final notarial deed
What you pay
balance, taxes and remaining expenses
If it goes wrong
you pay a building-land price with conditions unresolved
Resolve before signing
updated planning position, required documents and identified agreement obligations
Checks in order, before the deposit
- Identify every parcel in the price and any earlier subdivisions.
- Collect the CDU, the NTA articles and the building regulations, separating the plan in force from adopted changes and their dates.
- Have the technician place the project on the plan map and on a survey of the plot.
- Check that the use is allowed in the zone and sub-zone and, in Zone E, the personal and farm-business requirements.
- Ask for a calculation that separates net and gross site area, the index unit, existing volume, earlier transfers of building rights and the minimum plot.
- Have distances, height and the building’s position drawn, with constraints, access and services.
- Get a written opinion on your project and write into the contract what happens to the money if a check fails.
Sources: DPR 380/2001, Article 12; DM 1444/1968, Articles 2, 7 and 9; Civil Code, Article 1326; accessed 15 October 2026.
A page from a delivered report

Can you build on land in Italy? PRG, PUC and zoning
https://terrenocheck.it/en/guide/what-you-can-build-prg-italy
Checklist
Before a deposit on land you want to build on
Common questions
How can I check whether land in Italy is buildable before buying?
Obtain the cadastral identifiers, CDU planning certificate, municipal maps and applicable rules. A local surveying or architectural professional should compare them with your intended project, checking adopted plans, capacity already used, minimum plot size, setbacks and constraints. Request a written opinion before committing: a map colour or the description “building land” does not explain whether your particular project can proceed.
Can a non-farmer build a house on agricultural land in Italy?
The answer depends on the region, municipal rules and proposed work. Agricultural zoning alone gives no right to build a private home. For example, Article 73 of Tuscany’s LR 65/2014, consolidated text requires an agricultural business programme submitted by a professional agricultural entrepreneur for permitted new rural homes, alongside other conditions. Existing-building restoration and farm outbuildings need separate assessments.
How do you calculate permitted building volume on Italian land?
For a volume-based index, multiply the eligible area by the relevant index, then deduct existing countable volume and investigate any capacity already committed elsewhere. An area-based index produces floor area instead. Read the local definitions and the Intesa of 20 October 2016, Annex A: IF and IT use different land-area bases and include existing buildings in the allowance.
What is the difference between PRG, PUC, PUG and PGT?
These are names for planning instruments under different regional systems. PUC is used, for example, in Campania, Liguria and Sardinia; PUG in Emilia-Romagna; PGT in Lombardy. Veneto distinguishes PAT and PI. The name helps you find the documents. For a purchase, establish which plan is effective, which amendments have been adopted and which operational provisions apply to the plot.
Can I use the old PRG after a new plan is adopted?
Complying with the old plan is not enough. Where a project conflicts with an adopted plan, DPR 380/2001, Article 12(3) suspends decisions on the permit application. Safeguards cease after three years from adoption, or five where the plan was submitted to the competent approving authority within one year of publication ending. Your professional must check the actual documents, dates and applicable rules before advising on your application.
